Single-Wide Movers in Western NC

Moving a single-wide in western North Carolina typically runs $3,000–$8,000 for transport only — before permits, site prep, or setup. Also useful: mobile home moving, set-up and installation and re-leveling. Based in the Asheville, NC area. Moving, set-up and re-leveling across Western North Carolina.

Pictured: our yellow truck pulling a white single-wide down the highway.

Get a free estimate

Goes straight to us. We never sell or share your info.

Quick answer
Single-Wide Movers in Western NC

Moving a single-wide in western North Carolina typically runs $3,000–$8,000 for transport only — before permits, site prep, or setup. That range is real: a short haul near Candler prices toward the floor; a cross-county run from Black Mountain to Hendersonville with steep access and multi-county permits approaches the top. The NC tax moving permit, axle configuration, and whether the destination site has utilities stubbed all move the number.

19
federal disaster declarations on record in Buncombe County
Hurricane Dorian
most notable event in the federal record
1973–2026
span of the declaration record
Asheville
Buncombe County hub

One truck, one move — what the rig actually requires in these mountains

A single-wide on a transport frame is roughly 14 feet wide and up to 80 feet long. In Buncombe County, that geometry meets real mountain terrain: tight exits from older parks near Black Mountain, grade drops heading toward Swannanoa, and access roads on the western edge of Asheville NC that were graded for pickups, not oversize loads. A move from one of those parks to a new lot in Hendersonville — two counties, one continuous haul — is a representative example of what western NC single-wide moves actually require of the crew running it.

Two permits must be in hand before a wheel turns. The NCDOT Publication MH-2 governs oversize transport on state roads: most single-wides qualify as oversize by width alone, triggering escort requirements, route pre-approval, and time-of-day restrictions. The second permit — the one that most often delays jobs — is the NC tax moving permit under NCGS Chapter 105, Article 18, which certifies that property taxes on the home are paid before title can follow the move. That clearance is issued by the county where the home currently sits, not where it is going, and no truck should move without it.

A cross-county haul means a permit application for each county the load crosses. That coordination is the hauler's responsibility, not the homeowner's — but knowing it exists is how you evaluate whether a bid's timeline is realistic.

What the move involves, from disconnect to block-up

Every single-wide move follows the same physical sequence, though site conditions control how long each step takes:

  • Utility disconnect. Electric, water, and sewer or septic connections must be properly disconnected and capped before the home moves. Utility companies own that work, not the moving crew.
  • Skirting and underpinning removal. Crawl-space enclosure comes off. Most of it does not survive the move in reusable condition.
  • Blocking removal and axle-up. The home is unblocked from its current setup, the transport frame's axles are positioned and pinned, and the tongue is attached to the tractor. On sloped lots this step requires more staging room than most homeowners expect.
  • Haul and placement. The full western NC moving process is covered separately — mountain grades require lower speeds and longer stopping distances than flatland routes.
  • Setup and inspection at the new site. Setup and installation is a distinct scope from transport: blocking, anchoring, utility connection, and county inspection. Never assume it is included in the haul price without reading the contract line by line.

What it costs and what moves the number

Transport-only for a single-wide in western North Carolina typically runs $3,000–$8,000. That range reflects real variables: distance, grade, escort requirements, and the complexity of getting the home in and out of its current site. The table below maps common scope combinations to realistic price ranges — not guarantees, but a useful frame for reading a bid.

Move scopeTypical transport rangePrimary cost drivers
Short local move (same park or adjacent lot, under 5 miles)$3,000–$4,500Minimal route complexity, single-county permit
Mid-range county move (5–30 miles, moderate grade)$4,000–$6,000Oversize permit, possible escort, staging time
Cross-county haul (Buncombe to Henderson or similar) or steep access$5,500–$8,000Multi-county permits, escort, grade challenges

Setup, tie-down, skirting, and destination county permit fees are not transport costs — they are a separate line item. A quote that bundles everything without itemizing is difficult to verify; ask for line-item scope so you can compare bids honestly. The setup and installation page breaks out what that additional scope covers and its typical cost range in western NC.

The permit stack — what each document actually does

Three distinct permit categories apply to every relocation, and conflating them is how schedules slip.

Tax moving permit (NCGS Ch. 105, Art. 18). Issued by the county tax office where the home currently sits. Proves taxes are paid or that a payment arrangement is in place. The DMV cannot process title transfer at the new location without it.

NCDOT oversize transport permit. Route-specific — if the route changes, the permit changes. Publication MH-2 details the application process, escort requirements, and which roads require special approval.

Destination county building permit. Required before a relocated home can be legally occupied. The Henderson County permit process for manufactured homes illustrates what that review covers — setbacks, foundation type, utility connections, and anchoring. Buncombe County follows the same statewide framework under the NC Building Code Council's manufactured housing standards. The HUD Office of Manufactured Housing Programs sets the federal construction standards documented on the home's data plate; older homes may require additional work to meet current site-installation requirements.

After the truck leaves — anchoring, leveling, and the inspection that clears occupancy

Transport ends when the home is placed and blocked on the new lot. Legal occupancy does not begin until setup is complete and the county inspector has signed off.

Buncombe County falls in HUD Wind Zone I under 24 CFR 3280.305. The installation standard specifies anchor type, spacing, and soil conditions required at that classification — an installation that skips anchoring does not pass inspection and will not qualify for coverage under most manufactured home insurance policies.

Mountain lots in this region are frequently sloped, and how carefully the initial blocking is done determines how long the home stays level. A home blocked quickly on uneven ground will need re-leveling sooner than one set correctly from the start — and re-leveling is an additional cost that good setup prevents. A new site that requires grading or a different foundation type than the home's original install adds time before setup can begin, and blocking on fill that has not settled compounds the long-term leveling risk. Drainage around the new site matters too: water pooling against the pier system accelerates settlement and undermines anchor hardware over time.

Mountain weather and why timing matters for any western NC haul

Buncombe County has recorded 19 federally declared disasters over 1973-2026. The most recent sequence — a Winter Storm in 2026, a Tropical Storm in 2024, and hurricanes in 2023, 2021, and 2020 — reflects what late-season weather does to mountain access roads and creek crossings: saturated soil, road damage, and flooding that can delay or cancel a scheduled haul by days.

Spring and early fall are the most reliable moving windows in western NC. A home that is unblocked and on axles overnight is more exposed to weather than one that is fully set up and anchored, which is one practical reason to schedule the haul and the placement as back-to-back days rather than spreading a move across a week. Whatever the season, monitor the NOAA National Weather Service Asheville NC forecast through the full week before any scheduled transport — mountain systems move faster than coastal ones, and conditions in the French Broad watershed can shift overnight.

Buncombe County, NC: the storm record

Federally declared disaster events19
Named storms in the recordHurricane Dorian, Hurricane Florence, Hurricane Fran, Hurricane Helene, Hurricane Ian, Hurricane Isaias
Incident typesFire, Flood, Hurricane, Severe Storm, Snowstorm
Record span (fiscal years)1973–2026
Most recent declared incidentsWinter Storm (2026), Tropical Storm (2024), Hurricane (2023), Hurricane (2021)
HUD wind zone for manufactured homesZone I (24 CFR 3280.305)
Source: FEMA OpenFEMA disaster declarations. County-level federal declarations, not individual claims.
Questions people ask

Straight answers

How much does it cost to move a single-wide in NC?
$3,000–$8,000 transport-only is the typical range in western North Carolina. A short flat haul near Candler prices toward the floor; a cross-county run from Buncombe to Henderson County with steep access and multi-county permits approaches the top. Setup, permits, and utility work are costs beyond transport.
What is and is not included in a transport quote?
A transport quote covers the haul from origin to destination — axle-up, the drive, and initial placement. It typically does not include the NC tax moving permit, NCDOT permit fees, utility disconnects, skirting removal or reinstall, or the setup and installation scope at the new site. Always ask for a line-item breakdown before signing.
What permits do I need to move a single-wide in North Carolina?
At minimum: a tax moving permit from the county tax office under NCGS Chapter 105, Article 18, an oversize transport permit from NCDOT, and a building permit from the destination county for the installation. Cross-county hauls require a permit application for each county the load crosses.
How long does a single-wide move take from start to finish?
The haul itself is usually one day. The full timeline — permit approvals, utility disconnects, the move, setup, and county inspection — typically runs two to four weeks, depending on permit processing times and how much site prep the destination lot requires.
Is setup included with the move, or billed separately?
Setup is always a separate scope from transport. Blocking, anchoring to HUD Wind Zone I standards, skirting, utility connections, and the building inspection are installation work priced independently. See the setup and installation page for what that scope covers and its typical cost range.
What if my park entrance or access road is too tight for the truck?
Route and exit conditions should be assessed before the move date is set — that is part of the pre-move planning, not a day-of surprise. Tight entrances may require pre-coordination with utilities to temporarily raise lines, extra maneuvering time, or a staging area. These complications affect both schedule and cost.
When is the riskiest time to schedule a move in western NC?
Late summer through early fall, when tropical systems track inland up the French Broad corridor. Buncombe County has seen hurricanes in 2023, 2021, and 2020, plus a Tropical Storm in 2024 — saturated mountain roads and flooding can delay or cancel a haul. Monitor the NOAA National Weather Service Asheville NC forecast through the week before transport.
Our work

Our work

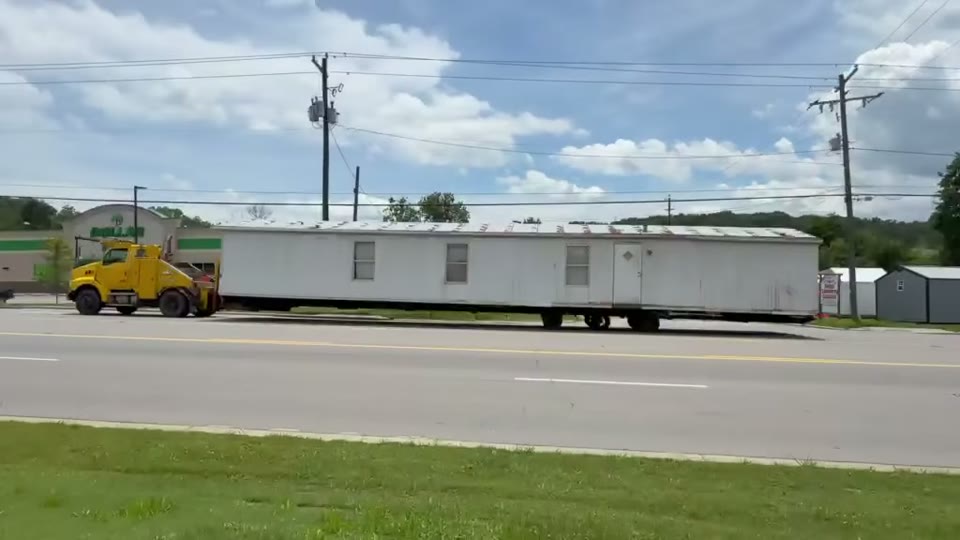

Our yellow truck pulling a white single-wide down the highway. Built by Asheville Modular and Mobile Home Services.
